I intend to employ Odoo as the operational software for a construction company comprising a workforce of approximately 20-30 workers.
The predominant proportion of our orders are fixed-price arrangements, wherein we establish a prearranged agreement with the client regarding the projected cost of the project. Throughout the construction process, it is necessary for us to consistently procure raw materials. In certain instances, the goods are promptly transported to the construction site and use it immediately, while in other cases, they are retained in our central warehouse for an extended period of time before being gradually distributed to the project.
How can I effectively manage this process in Odoo?
Unfortunately, in my particular circumstance, associating the analytic account with the purchase order and project is insufficient, as the purchase order may contain multiple construction materials for numerous projects. In other words, I have to calculate the actual utilization of raw materials at the construction site.

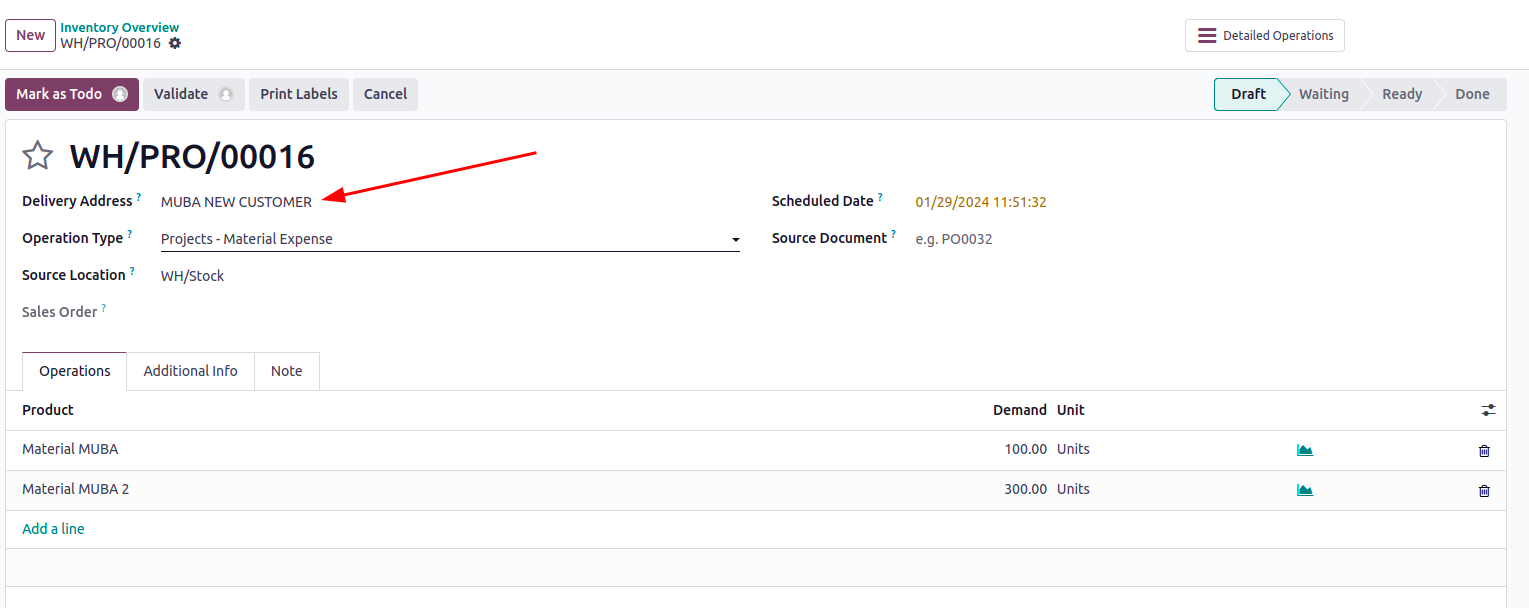

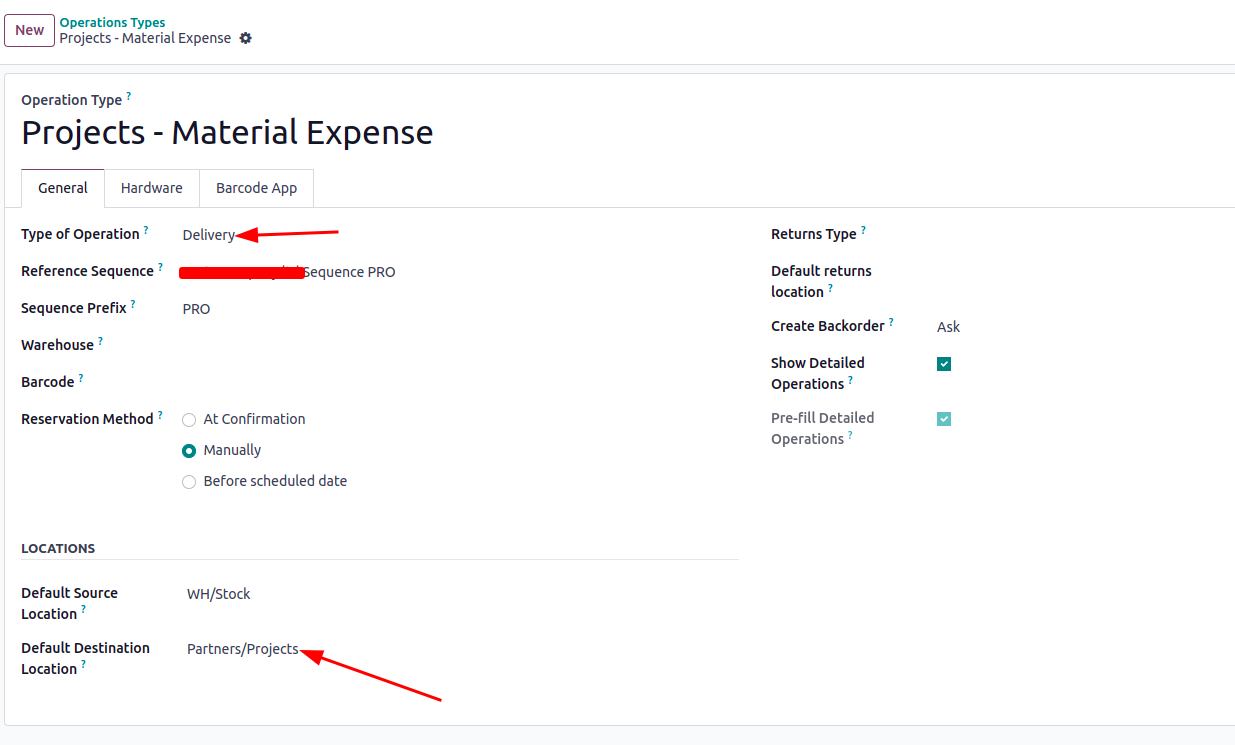

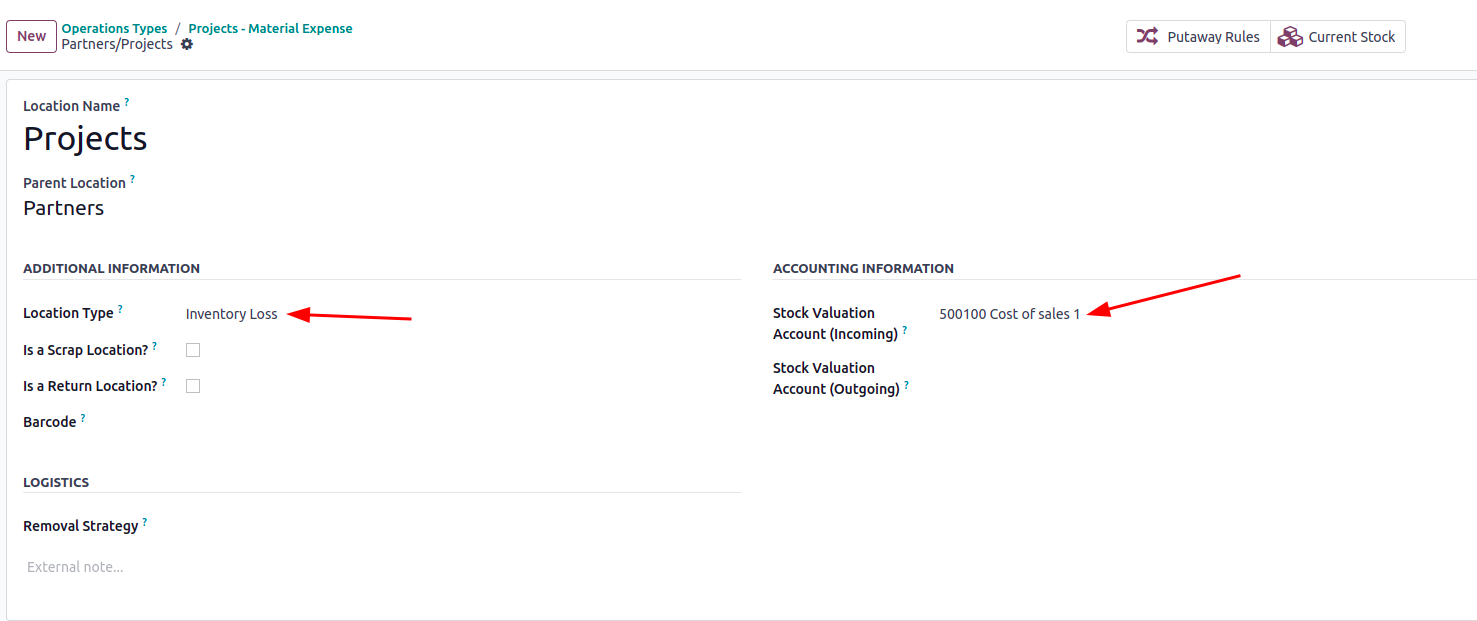

Furthermore, I don't know how to set this up in the inventory application due to the absence of project addresses (construction site location) within the project application. Or how to "consume" products in a project.
I am also interested in obtaining information regarding the timing, quantity, and type of raw materials consumed for a specific task within a given project. This data will enable me to monitor our progress in relation to the planned budget.
Hi @Mujtabaa Bashir,

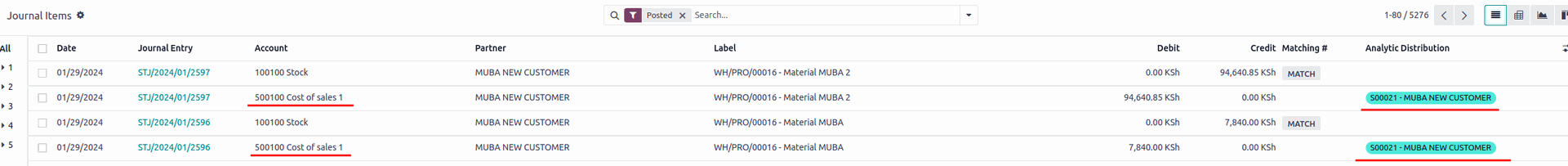

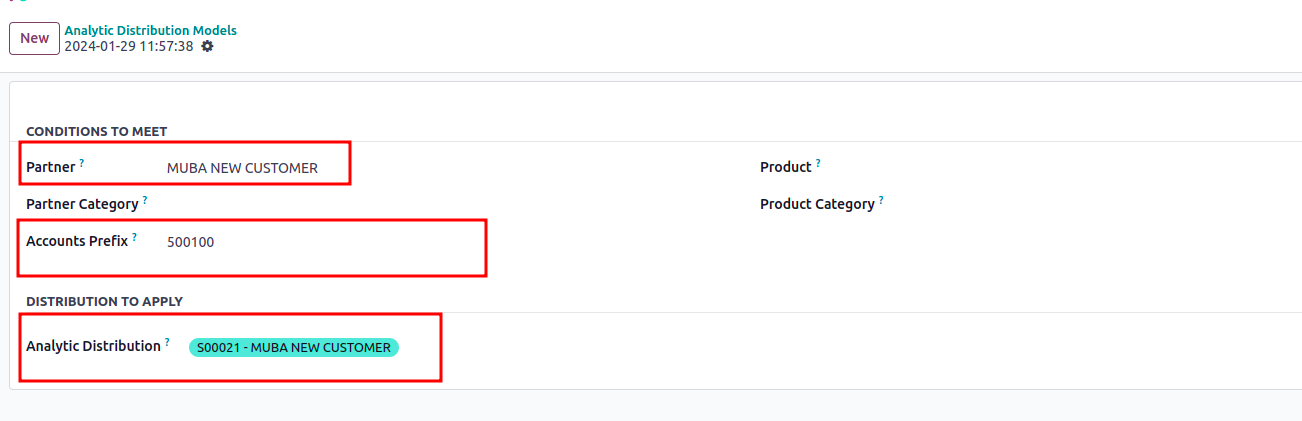

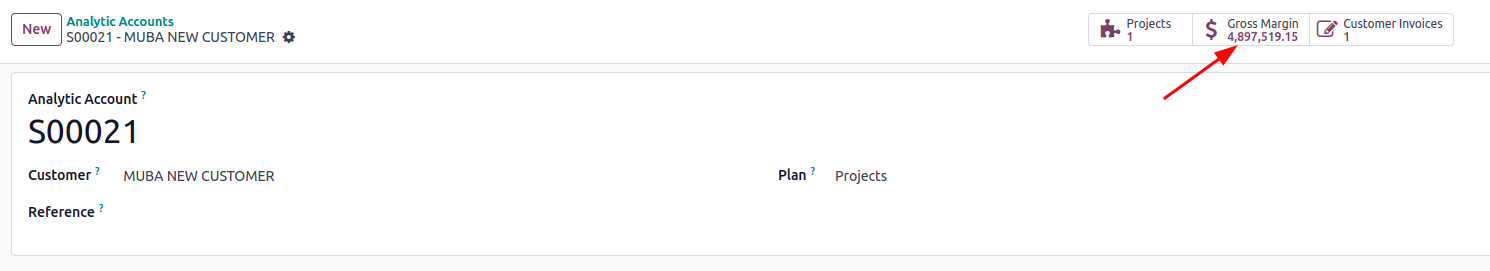

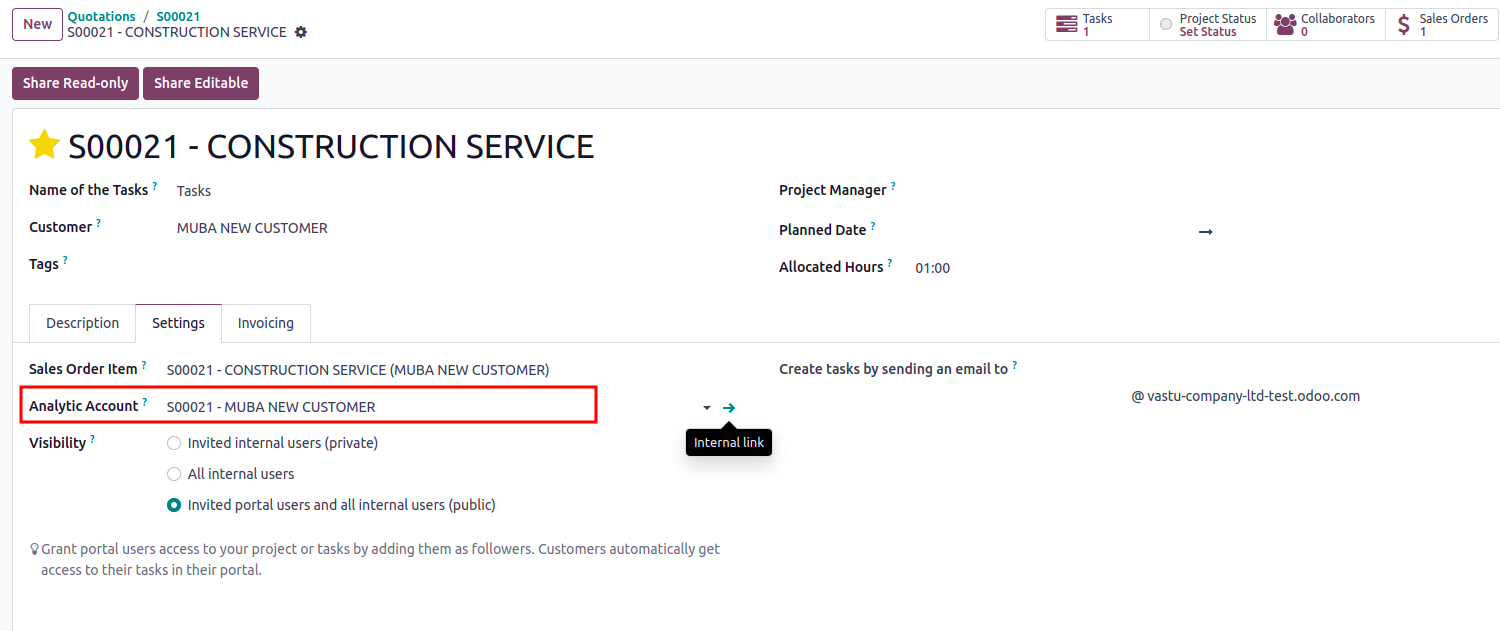

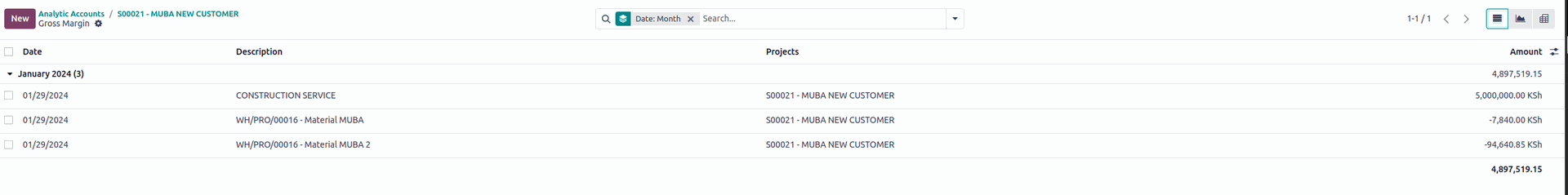

Your solution is very promising, however for some reason the profitability under project status is not updated with the consumed materials.
Do you know why?
